Method Statement for Asphalt Works

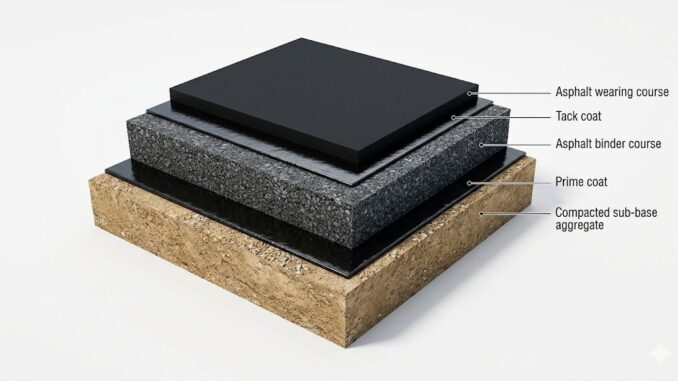

3D isometric cross-section diagram showing asphalt road layers: sub-base, prime coat, binder course, tack coat, and wearing course.

Document Details (Generic)

  • Discipline: Civil

  • Trade: Roads & Pavements

  • Document Type: Method of Statement (MOS)


1. Purpose & Scope

The primary objective of this method statement is to provide a standardized, documented procedure for asphalt works. This procedure covers all asphalt-related activities and ensures proper execution across construction sites.

2. Definition & Abbreviation

  • Bench mark/Reference point: A surveyor’s mark established on a stationary object of known position and elevation, utilized as a construction reference.

  • IFC: Issued for Construction drawings

  • ITP: Inspection Test Plan

  • CAR: Corrective Action Request

  • NSL: Natural Surface Level

  • PTS: Project Technical Specification

  • MC: Medium Curing

  • RC: Rapid Curing

3. References

  • IFC Drawings

  • Approved Material Submittals

  • PTS (Project Technical Specifications)

  • AASHTO-M20: Aggregate for Concrete

  • AASHTO-M43: Standard Specification for Sizes of Aggregate for Road and Bridge Construction

  • AASHTO-M81: Coarse Aggregate for Portland Cement Concrete

  • AASHTO-M140: Cement

  • AASHTO-M283: Coal Fly Ash and Raw or Calcined Natural Pozzolan for Use in Concrete

  • ASTM 0692: Standard Test Method for Specific Optical Density of Smoke Generated by Solid Materials

  • ASTM 01073: Standard Test Methods for Analysis of Calcium Chloride

  • ASTM 01241: Standard Test Method for Slake Durability of Shales and Other Similar Weak Rocks

  • BS1707 or IS:217: Specification for Copper and Copper Alloy Ingots and Castings

  • IS:454: Code of Practice for General Construction of Plain and Reinforced Concrete for Dams and Other Massive Structures

  • IS:8887: Specification for Water for Making Concrete

4. Responsibilities

  • Project/Construction Manager: Bears overall responsibility for the implementation and continuous monitoring of all asphalt-related activities outlined in this method statement.

  • Site Manager: Responsible for overarching direction, coordination, and monitoring of all site execution activities related to asphalt works.

  • Site Engineer: Directly plans and executes field activities. Responsible for preparing the asphalt plan, developing the safe work plan, and applying for work permits prior to excavation/paving.

  • QA/QC Engineer: Conducts monitoring tests in compliance with the approved ITP. Coordinates with independent testing laboratories and verifies that asphalt works align with the IFC drawings and ITP.

  • Foremen: Directs the physical execution of asphalt works. Issues instructions to the workforce, ensures proper use of tools/equipment and PPE, and maintains housekeeping around the active work area.

  • Surveyor: Establishes site benchmarks and monitors grade elevations. Assesses asphalt surface smoothness, maintains daily logs, records as-built deviations, and conducts the final survey for handover documentation.

  • HSE Engineer/Supervisor: Reviews the Safe Work Plan and work permits before activity commencement. Prepares and submits necessary HSE documentation to the client/customer.

5. Tools & Equipments

Vector illustration of essential asphalt paving equipment including paver machines, vibratory rollers, and bitumen sprayers.

  • Dozer

  • Bitumen Sprayer vehicle

  • Pressure Distributes Roller

  • Loader

  • Motor Grader

  • Dump Truck

  • Vibrator Roller

  • Plate compactor

  • Paver Machine

  • Water Boozer

  • Theodolite with tripod

  • Automatic level with tripod and staff rod

  • Metal detector / Cable detector

6. Procedure

The execution of asphalt procedures is categorized into the following sequential stages: Sub-Base, Prime Coat, Binder Course, Tack Coat, and Wearing Course.

6.1 Sub-Base Preparation

  • Execute grading to achieve the proposed grades as indicated on the approved IFC drawings.

  • Check and verify all final levels.

  • Conduct density tests at randomized locations, with frequency dictated by specifications, to determine the degree of compaction.

  • Ensure aggregate sub-base material is tested and approved by an independent laboratory.

  • Place approved sub-base material in layers not exceeding 30 cm, or strictly according to company specifications.

  • Spread, level, and compact the sub-base layer using steel-wheel tandem vibratory rollers and pneumatic-tired rollers.

  • Verify finalized dimensions and levels on the compacted layer.

  • Execute third-party density and compaction tests as specified.

6.2 Prime Coat Application

  • Thoroughly clean the full width of the surface using compressed air immediately prior to application.

  • Ensure the prime coat material has received preliminary approval.

  • Apply bituminous material via spray tankers in a single, uniform layer.

  • Maintain an application rate between 0.7 to 1.5 liters/sq.m, adhering to company specifications.

  • Keep application temperature below 70°C.

  • Allow the sprayed area to cure for more than 24 hours until all excess prime coat has completely evaporated.

6.3 Binder Course Application

Construction crew using an asphalt paver machine to lay hot mix asphalt, followed immediately by a tandem roller for compaction.

  • Verify binder quality adheres to AASHO-T182 or IS:73, IS:217, IS:454, and IS:8887.

  • Clean the primed surface with compressed air, ensuring it is completely dry before paving.

  • Transport hot asphalt mix from the mixing plant using wheel trucks and dump it directly into the asphalt paver.

  • Lay the material to the specified thickness and level.

  • Commence compaction immediately after spreading.

  • Execute breakdown rolling at a temperature of 110-120°C using tandem rollers, followed by pneumatic-tired rollers.

  • Begin rolling from the outer edges and proceed toward the center, ensuring each trip overlaps the previous pass by at least 30 cm.

  • Keep roller wheels moistened and operate smoothly without backlash to prevent surface tearing.

  • Eliminate any waves using heavy tandem rollers.

  • Achieve full compaction before the asphalt temperature drops to 100°C.

  • Prepare construction joints by vertically cutting the layer with an asphalt saw or jackhammer. Clean the joint, apply compressed air, and coat with tack material on vertical/horizontal surfaces for optimal bonding.

  • Compact inaccessible areas using plate compactors or hand tampers.

  • Once the base course reaches the top level, dump suitable fill material (dune sand) on the road shoulders, level it, shape it to a 1:6 ratio, and compact to 90% maximum dry density.

6.4 Tack Coat Application

  • Apply primarily approved tack coat material at a rate of 0.3 to 0.6 liters/sq.m.

  • Maintain temperature not exceeding 54°C above the binder temperature (or per manufacturer specifications).

  • Cure the surface until a tacky, sticky surface is visible.

6.5 Wearing Course Application

  • Spread the hot asphalt mix over the cured tack coat using an automatic asphalt paver according to the approved profile and thickness.

  • Compact the mix as soon as possible after spreading.

  • Conduct breakdown rolling at 110-120°C using tandem rollers.

  • Continue compaction with self-propelled and tandem rollers starting from the sides and moving toward the center, overlapping previous trips by at least 30 cm.

  • Maintain moistened roller wheels, reverse without backlash, and utilize heavy tandem rollers to eliminate any surface waves.

  • Complete full compaction before the surface temperature reaches 80°C.

  • Restrict all traffic on the newly paved layer for a minimum of 12 hours until it is adequately cooled.

  • Repair any core test holes with hot asphalt mix and compact thoroughly using a Marshal Hammer.

7. Inspection & Testing

Close-up of a cylindrical asphalt core sample extracted from a newly paved road for laboratory quality control testing.

  • Ensure all testing is conducted by an approved, independent third-party site laboratory.

  • Carry out all field inspection and testing activities in strict alignment with the approved ITP.

  • Maintain and prepare all relevant QC records through the Contractor’s QC Engineer.
